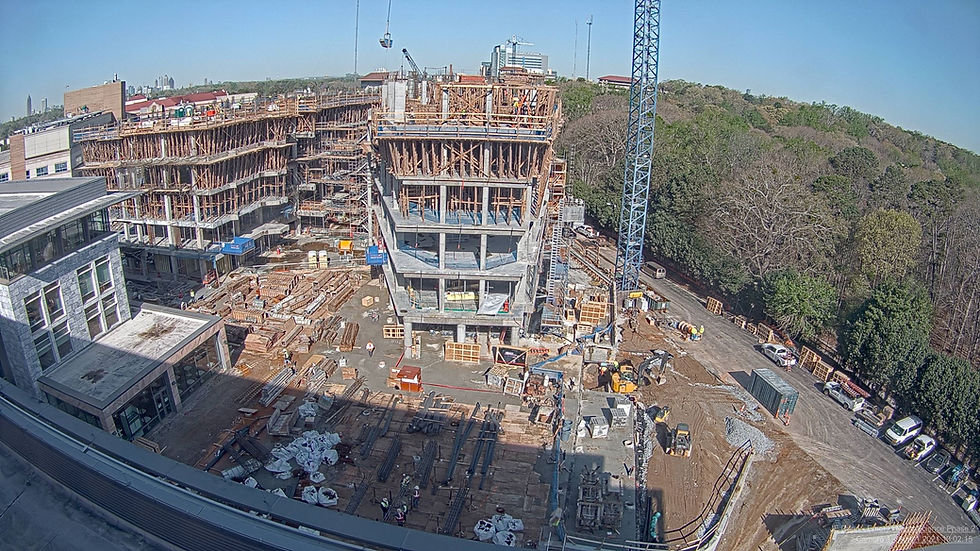

Construction Update - 4/2/2021



The HSRB – II job site is continuing to perform work on site under modified site rules that take into account the latest recommendations from the CDC. The project will continue as long as we feel that everyone on the job site can continue to do so safety. The additional safety measure of taking the temperature of everyone who comes on site will continue until further notice.


This past week's (3/29/21 to 4/02/21) scheduled work activities:

G2/G1

  • Starting CMU at Loading Dock – G-1.

  • Continued building out electrical rooms on G-2 & G-1 .

  • MEP installation Continues G-2 & G-1.

  • Framing and hanging walls G -2 & G-1 .

Level 1

  • CMU Installation continues on level L1 North Tower.

  • Electrical Room A build out.

  • Installation of conduit and piping underway at South Tower.

  • Installation of glazing and frames for exterior glass underway on L-1.

Level 2

  • Overhead conduit installation North Tower.

  • Framing priority walls – level 2 SW.

  • Elevator Steel and Duct shaft steel Installation.

  • Detailing West Bridge.

Level 3

  • Shoring timbers removal level 3 pour 1 area.

  • Layout of priority walls – NE.

Level 4

  • Detailing Center Bridge.

Level 5

  • Shoring timbers in place.

Level 6

  • Placing and setting columns level 6 pours 2 & 3.

  • Concrete slab pour scheduled for area 6-3 on Friday 4/2/24 @ 2:30 AM.

  • Rebar installation in area 6-3 & 6-4 were underway this past week.

Mechanical Penthouse

  • Forming/placing of columns for in area 6-1.

Site

  • Pulling of electrical feeders in micro-grid vault continues.

  • Work on exterior mock up continues .

  • Work on Generator yard retaining wall forms completed, pour schedule for 4/2/21.

Next week's (4/05/21 to 4/09/21) scheduled work activities:

G2 & G1

  • Drywall framing Non-priority walls G- 2.

  • Installation of Elevator 3 & 4 shaft walls G-2.

  • Exterior Masonry Installation G-1.

  • Overhead MEP Installation continues G-1.

  • Lighting conduit installation – G1.

  • Electrical Room A Build out G-1.

Level 1

  • Framing & Glazing installation – North Tower.

  • Overhead duct work continues.

Level 2

  • Overhead conduit Installation North Tower.

  • Frame & top out priority walls – SW.

  • Storm & Sanitation drain installation – North & South towers.

Level 3

  • Shoring timbers removed at level 3 – 1 pour.

  • Layout of Priority walls – NE.

  • Center Bridge Detailing.

Level 4

  • Steel detailing on center bridge work continues.

Level 5

  • Shoring timbers remains in place.

Level 6

  • Place and set columns level 6 – pour 3.

  • placing & setting columns- level 6 pour 4.

  • Concrete pour scheduled for area 6-4 scheduled for 4/7/21.

Mechanical Penthouse

  • Installation of formwork for areas at 6-1 continues.

Site

  • Pour Planter wall footing.

  • Pour Safety Handrails

  • Micro- Grid Generator Yard knee wall installation continues
