The HSRB – II job site is continuing to perform work on site under modified site rules that take into account the latest recommendations from the CDC. We will continue as long as we feel that everyone on the job site can continue to do so safety. Effective Monday, August 9, 2021 Je Dunn will reinstitute/require the wearing of face masks on the job site. Additional new policy may be added in the future.
This past week's (10/25/21 to 10/30/21) scheduled work activities:
G2
Radio-pharmacy Hot cells installation is Continues .
Opening in the Cyclotron vault wall has been filled in with concrete.
Overhead rough-in continues of overhead ceilings, lights and air diffusers.
H2I mobilized this week and began installation of some lab casework.
G1
Wall framing in G1 BSL - North area continues.
Plywood installed in the 7 T MRI room.
In wall & ceiling rough – in continues in BSL- North & South area.
Stonehard Installation started Vivarium South.
In wall rough -in of utilities at G1 south BSL rooms continues
Installation of Elevator 4 continues.
Installation of 015 cabinet and SAT is completed.
Level 1
Office & corridor lighting installation underway.
Tile installation in showers on L1 North has begun.
Wall cover up inspections are underway on L1 offices.
Level 2
Erection of steel for East connector bridges continues.
Community restroom wall & ceiling cover ups are completed.
Lab neighborhood wall and hard ceiling cover ups continues.
Level 3
Lab Neighborhood wall & hard ceiling inspections underway.
MEP rough in at bridges underway.
Hanging and finishing of drywall - North offices continues.
Level 4
Lighting Rough-in in @ hard ceilings in South Tower continues.
Community restroom hard ceiling inspections underway.
North Offices- hanging and drywall walls and ceilings.
Level 5
Hanging of drywall in North & South Towers offices continues.
Community restroom hard ceiling rough – in underway.
Level 6

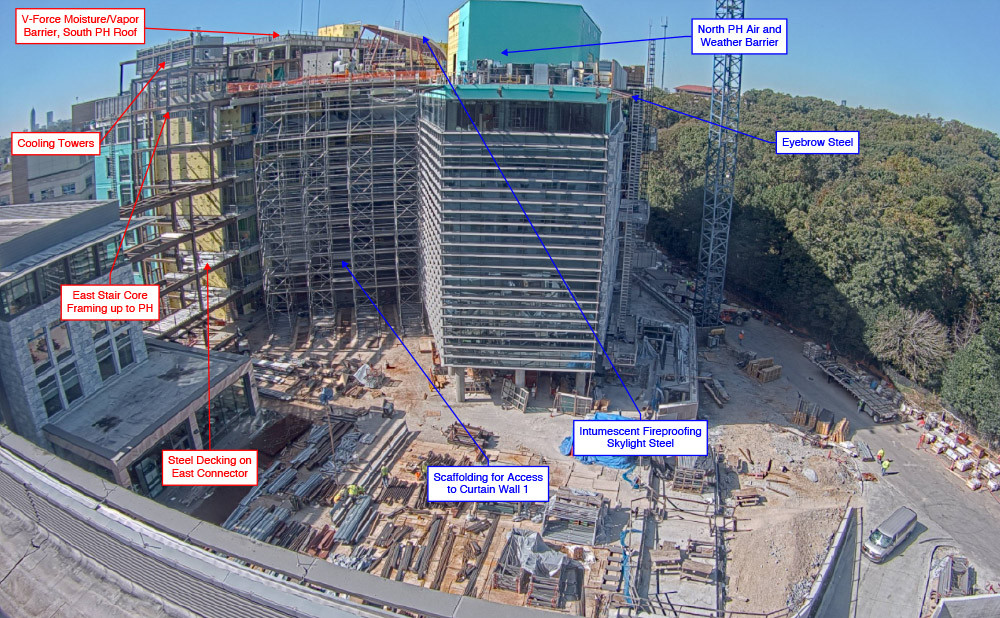

Installation of “eyebrow” steel on exterior level 6 continues.
Fire proofing of eyebrow steel continues.
Installation of Phoenix valves continues.
Mechanical Penthouse
MEP Installation continues in South & North towers.
Installation of vapor barrier roofing layer on South Tower Mechanical roof is completed.
Exterior framing & sheathing continues on South tower mechanical penthouse roof parapet wall.
Air and water barrier installation continues on exterior walls North & South Towers.
Fireproofing of skylight structural steel continues.
Skin:
Marble installation and caulking on Northeast & Northwest Façades continues.
Marble installation and caulking on the West Façade has begun.
Installation of windows in punched openings on South Façade continues.
Granite installation on Northwest Façade continues.
Glazing Installation in G-1 lobby area continues.
Curtain wall #1 scaffolding is completed.
HSRB – I Vivarium Expansion:
Erection of steel columns and beams continues.
Next week's (11/01/21 to 11/06/21) scheduled work activities:
G2
Finish hanging of the ceilings.
H2I installation of lab casework to continue.
G1
Installation of 3T & 7T shielding begins.
Finish hanging drywall in the North Vivarium.
In wall rough- in continues – BSL North & South.
Level 1
Office & corridor lighting installation continues.
Tile installation in showers - North.
Plumbing fixture installation in community restroom underway.
Level 2
Lab Neighborhood wall & hard ceiling cover ups continues.
Community restroom wall & floor tile installation is underway.
Lighting installation in North Offices has begun.
Level 3
Lab Neighborhood wall and ceiling cover up is underway.
MEP rough -ins at bridges.
Level 4
Community Restroom hard ceiling inspections.
Lighting Rough - in at hard ceilings South Tower.
Hanging and finishing or drywall North Offices.
Level 5
One siding of drywall – North & South Towers continues.
Lighting rough in at hard ceilings continues.
Community restroom in wall inspections underway.
North offices in wall & hard ceiling inspections underway.
Level 6:
Installation of eyebrow steel continues.
Fireproofing of eyebrow steel & east truss underway.
Mechanical Penthouse
Installation of overhead MEP Continues – North & South Towers
Exterior framing and sheathing of South penthouse continues.
Air & water barrier installation on exterior sheathing of North & South Tower continues
Framing of plywood band for skylight.
Electrical panel energization and BAS terminations.
Skin
Air and Water Barrier installation continues.
Punched window openings aluminum surrounds installation continues on South elevation.
Marble installation continues on Northwest & Northeast Façade.
Marble installation will begin on MC # 6 (master climber)
Installation of fire rated frames on L-1.
HSRB – I Vivarium Expansion:
Continue installation of steel beams & Columns.
Comments
